Kitchen Cabinet Lead Times in 2026: RTA vs Assembled vs Custom
You have the layout planned, the countertops picked, and the contractor lined up. The one question that determines whether all of those pieces come together on time: when will your cabinets actually arrive?
A vague estimate like “four to twelve weeks” is not a timeline. It is a guess, and guesses cause scheduling disasters. Contractors charge rescheduling fees when materials arrive late. Countertop fabricators push you to the back of their queue if base cabinets are not installed on template day. One missed delivery window can cascade into weeks of delays.
This guide breaks down exactly where the time goes during a cabinet order so you can plan your renovation around hard numbers, not hope.

Typical Kitchen Cabinet Lead Times by Type
Ready-to-assemble cabinets arrive the fastest. Custom builds take the longest. Assembled cabinets sit in the middle. Here is what you can realistically expect:
RTA (In Stock)
1 to 3 days
0 days (you assemble)
3 to 7 days
1 to 2 weeks
Assembled
1 to 3 days
5 to 10 days
3 to 7 days
2 to 4 weeks
Custom Builds
5+ days
4 to 8 weeks
1 to 2 weeks
6 to 12 weeks
Common Mistake: When people hear “lead time,” they assume it means “shipping time.” It does not. Total lead time equals processing time plus assembly time (if applicable) plus transit time plus the delivery appointment window. Confusing the two causes the most common scheduling disasters in kitchen remodels.
Keep in mind that timelines shift based on the specific product line and seasonal demand. A rush order in October (when holiday remodel deadlines pile up) takes longer than a standard order in February. More on seasonal factors below.
Curious about your options? Browse all kitchen cabinets to get a sense of what is available before you lock in your timeline.
RTA Cabinet Lead Times
Buying ready-to-assemble (RTA) cabinets is the fastest path to a finished kitchen. When a retailer says a cabinet is “in stock,” that means the flat-pack boxes are sitting on a warehouse shelf waiting for a shipping label. It does not mean the truck drops them off tomorrow morning.
Here is exactly how an RTA order flows:
- You place your order and confirm the details.
- The warehouse team spends one to three business days pulling your specific flat-pack boxes and palletizing them.
- A freight carrier picks up the pallet from the loading dock.
- The truck drives across the country over the next three to seven days, depending on distance.
- The freight company calls you to schedule a delivery appointment.
At Kitchen Cabinet Kings, our RTA cabinet orders typically arrive within 7 to 14 business days from the date your order is processed.
Budget time for assembly after delivery. RTA cabinets arrive as flat-pack boxes that you (or your contractor) assemble on-site. If you are doing it yourself, plan for one full day to assemble a small kitchen (10 to 15 cabinets) and two days for a larger kitchen (20+ cabinets). An experienced contractor can cut that time roughly in half. Factor this into your schedule between delivery day and installation day.
If you have a tight deadline, a DIY mindset, or a contractor ready to go, RTA cabinets are the fastest option available.
Assembled Cabinet Lead Times
Ordering assembled cabinets takes longer because there is a build phase before anything is loaded onto a truck. Warehouse workers unpack the flat boxes, apply wood glue, drive the staples, attach the hinges, and pack the finished cabinets into heavy-duty shipping crates.
Think of your timeline as a math equation:
Processing (2 days) + Assembly (7 days) + Transit (5 days) + Delivery Scheduling (3 days) = roughly 17 days total.
At Kitchen Cabinet Kings, choosing assembled cabinets adds 7 business days to your order compared to the same cabinets ordered as RTA. Our assembled kitchen cabinets arrive fully built, ready to install the day they show up.
The delivery appointment variable catches people off guard. Freight companies do not drop fully built cabinets on your porch unannounced. They call you to schedule a specific delivery window. If you miss that call, your cabinets sit in a freight terminal until you reschedule, and that can add three to five days to your timeline.
Pro Tip: When your order ships, save the freight carrier’s tracking number and phone number. Set a reminder to check for their scheduling call. Responding within 24 hours keeps your timeline on track.
Custom and Made-to-Order Cabinet Lead Times
Custom cabinets take the longest because the manufacturer builds everything from raw materials after you pay. The factory batches similar orders together, wood requires specific curing times for paint and stain finishes, and quality control teams measure and inspect every piece before it ships.
Expect 6 to 12 weeks for most custom orders, with some complex builds running longer. The wait makes sense if you have non-standard dimensions (a 47-inch base cabinet that no stock line carries), unique color-matching requirements, or highly specialized storage inserts that only a custom shop can produce.
If your deadline is tight, consider semi-custom assembled lines that offer a wide range of modifications (non-standard heights, custom paint matches, specialty accessories) without the 12-week wait. Semi-custom typically runs 4 to 6 weeks, splitting the difference between stock assembled and full custom.
What Impacts Cabinet Lead Time the Most
Several moving parts determine when your delivery truck actually turns onto your street. Focus on the factors within your control to prevent unnecessary delays.
Stock Status and Backorders
Stock status causes the biggest headaches. One missing 36-inch sink base cabinet can pause your entire 20-cabinet order. Always check inventory levels before you commit to a specific door style.
Ask the retailer if they do partial shipments (sending what they have now and mailing the backordered piece later). Partial shipping works well if the missing piece is a small trim item or a piece of crown molding. It fails completely if the missing piece is the corner base cabinet your entire layout depends on.
If you are flexible on style, check which door styles the retailer keeps in deep stock. White shaker cabinets and gray shaker styles almost always have the best availability because manufacturers keep the largest quantities on hand.
Freight Scheduling and Delivery Windows
Cabinet delivery is not like an Amazon package showing up on your doorstep. Freight delivery requires a scheduled appointment window, and understanding the process prevents surprises.
Curbside vs threshold delivery: Curbside delivery means the driver leaves the pallet at the end of your driveway. No unpacking, no carrying inside. Threshold delivery gets the cabinets to your front door or garage, but the driver will not place them in your kitchen. Know which option you are getting before delivery day.
“Shipped” does not mean “arriving tomorrow.” Once your cabinets leave the warehouse, the freight company calls to arrange a delivery window. If you miss that call, your cabinets sit in a freight terminal. Respond within 24 hours to keep your schedule intact.
Delivery day checklist:
- Confirm the delivery window with the carrier at least 48 hours in advance.
- Clear space in your garage or entryway for the pallet (assembled cabinets take up significant floor space).
- Have someone available to inspect every box for shipping damage before signing the bill of lading.
- Note any visible damage on the delivery paperwork before the driver leaves.
Seasonal Demand and Holiday Schedules
Cabinet lead times are not constant throughout the year. Understanding the seasonal patterns helps you plan around the slowdowns rather than running into them.
Spring rush (March through June): This is the busiest season for kitchen remodels. Manufacturers and freight carriers are at peak capacity. Orders placed in April may take one to two weeks longer than the same order placed in January.
Holiday season (October through December): Homeowners trying to finish before Thanksgiving, Christmas, or New Year’s Eve create a second demand spike. If your install deadline falls in late November or December, order at least two weeks earlier than you normally would.
Manufacturer shutdowns: Many cabinet manufacturers close for one to two weeks between Christmas and New Year’s Day. Orders placed in mid-December may not begin processing until early January. If your project timeline crosses this window, account for it.
The sweet spot: January through early March and July through September typically have the shortest lead times. If your schedule is flexible, ordering during these windows gives you the fastest turnaround.
How to Keep Your Remodel on Schedule
If you want to keep your renovation on track, work backward from your installation date. Planning forward from the day you order almost always leads to mistakes because you underestimate how many steps sit between “order placed” and “cabinets installed.”

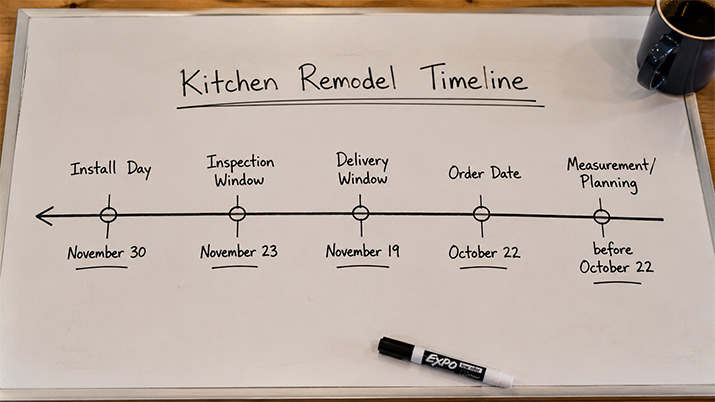

Backward-Planning Example: November 30 Install Date
Here is what backward planning looks like with a real date. Say your contractor wants to start installing base cabinets on November 30.
Install Day: November 30.
Inspection Window: November 23. You need cabinets in your house by this date. A full week before installation gives you time to open every box, check for shipping damage, and request replacement parts if anything arrived dented or scratched.
Delivery Window: November 19. If you need cabinets in-house by November 23, the freight carrier must call you by November 19 to schedule the delivery appointment.
Order Date: October 22. For an assembled kitchen from Kitchen Cabinet Kings, you need to place your order at least 4 weeks before November 19. That means clicking “checkout” no later than October 22.
Measurement and Planning: Before October 22. Your kitchen layout, appliance selections, sink model, and filler piece needs must all be finalized before you order. Our measuring guide walks through every dimension you need to capture, and our free 3D design service can finalize your layout if you want professional help.
A Pre-Order Checklist to Prevent Reorders
Before you hit “place order,” double-check every detail. Skipping even one can trigger a reorder that adds weeks to your timeline.
Appliance specifications: Confirm your refrigerator, oven, dishwasher, and microwave dimensions before ordering the cabinets that surround them. A 36-inch refrigerator will not fit in a 33-inch opening, and discovering that after the cabinets arrive means a reorder.
Ceiling height: Measure your ceiling height in multiple spots (older homes often have variations). If your upper cabinets are sized for a standard 96-inch ceiling and yours is 93 inches, you have a problem.
Filler and panel needs: Fillers close the gaps between cabinets and walls. Panels cover exposed cabinet sides. Forgetting these leaves visible gaps that look unfinished.
Corner configurations: Corner base cabinets and corner wall cabinets come in specific configurations (blind corner, lazy susan, diagonal). Choosing the wrong one wastes space or creates a cabinet that does not function.
Trim selections: Crown molding, light rail, and base shoe trim finish the look. Ordering them with your cabinets ensures the finish matches. Adding them later risks a color mismatch and a separate shipping charge.
Pro Tip: Finalize your exact ceiling height, your specific refrigerator model number, your filler pieces, and your trim selections before you place the order. Skipping any one of these details is the most common reason people end up making a second order and losing weeks.
Quick-Ship Strategy for Time-Sensitive Remodels

Sometimes you do not have a month to wait. If a pipe bursts and ruins your kitchen, or if a house flip needs to close in three weeks, you need cabinets fast. To get them fast, you trade customization for speed: standard sizes, standard colors, in-stock inventory.
White shaker and gray shaker styles almost always ship the fastest because manufacturers keep the largest quantities on hand. If you stick to standard 15-inch, 18-inch, and 24-inch widths instead of hunting for a rare 13-inch cabinet, your order will fly through the warehouse.
Here is how the options compare when you are racing the clock:
Quick-Ship Cabinets
1 to 2 weeks
Popular styles, standard colors, common sizes
Best for: Hard deadlines, emergency remodels, house flips, rental properties
Standard Cabinets
2 to 6 weeks
Wider range of colors and sizes
Best for: Homeowners who want variety and can wait a few weeks
Custom Cabinets
6 to 12 weeks
Full customization of styles, finishes, and sizes
Best for: Unique layouts, luxury builds, or non-standard dimensions
If you are not sure which style fits your layout, our complete cabinet buying guide walks through every decision from style to sizing.
Start Shopping by Your Timeline

Your contractor is ready. Your countertops are on order. The only thing standing between you and a finished kitchen is the cabinets.
If your contractor is ready to start within the next two weeks, shop RTA kitchen cabinets for the fastest possible shipping. RTA orders from Kitchen Cabinet Kings typically arrive within 7 to 14 business days.
If you have a few extra weeks and prefer to skip the assembly phase, shop assembled kitchen cabinets for a head start on installation day. Assembled orders add 7 business days to the timeline but arrive ready to install.
If you are still in the planning phase, order cabinet door samples so you can compare finishes under your own kitchen lighting before committing. And if you need help with layout and sizing, our free 3D design service pairs you with a certified designer who handles the measurements for you.
Frequently Asked Questions
How long does it take to get kitchen cabinets delivered?
RTA cabinets that are in stock typically ship within a few business days and arrive within 1 to 3 weeks depending on transit distance. Assembled cabinets take 2 to 4 weeks because they include a build phase before shipping. Custom orders run 6 to 12 weeks. Always add a buffer of at least one week for delivery appointment scheduling and damage inspection.
Do assembled cabinets take longer than RTA?
Yes. Assembled orders include processing, assembly, and transit time, while RTA orders skip the assembly step entirely. At Kitchen Cabinet Kings, choosing assembled adds 7 business days compared to an equivalent RTA order. Expect assembled orders to take roughly 1 to 2 weeks longer overall.
What causes cabinet delivery delays most often?
The three biggest delay causes are out-of-stock items that hold up an entire order, missed delivery appointment calls that push scheduling back by days, and orders placed without confirming appliance dimensions or filler needs, which trigger costly reorders. Checking stock levels and finalizing all measurements before ordering prevents most delays.
When should I order cabinets before my installation date?
Order at least 2 to 3 weeks before your target install date for RTA, and 4 to 6 weeks for assembled. Add an extra week for inspection and any replacement parts. Working backward from your install date is the safest planning method: start with the install date, subtract transit time, assembly time, and processing time to find your order deadline.
Should I schedule my installer before cabinets arrive?
No. Schedule your installer after delivery and a full inspection. Rescheduling a contractor because cabinets have not arrived or need replacement parts costs more than waiting a few extra days. Open every box, check every door and panel for damage, and confirm all pieces are accounted for before your installer starts.
How long does a full kitchen remodel take from start to finish?
A typical kitchen remodel takes 6 to 12 weeks from demolition to completion. Cabinet lead time is the single biggest variable in that timeline. If you order RTA cabinets with fast shipping, you can compress the total project to 6 to 8 weeks. If you order custom cabinets with a 12-week lead time, the total project may run 16 to 20 weeks including design, demolition, plumbing, electrical, cabinet installation, countertop fabrication, and finishing work.
Can you speed up kitchen cabinet delivery?
Yes, by choosing in-stock RTA cabinets in popular styles and standard sizes. White shaker and gray shaker cabinets almost always have the fastest availability. Sticking to standard widths (15-inch, 18-inch, 24-inch) rather than uncommon sizes ensures your order ships from existing inventory rather than waiting for a production run.
What is the difference between RTA and assembled cabinets?
RTA (ready-to-assemble) cabinets ship as flat-pack boxes that you or your contractor assemble on-site. They cost less and arrive faster. Assembled cabinets are built at the warehouse before shipping and arrive ready to install. They cost more and take longer to deliver, but you skip the assembly step entirely.
How long does it take to assemble RTA cabinets?
Plan for one full day to assemble a small kitchen (10 to 15 cabinets) if you are doing it yourself, or two days for a larger kitchen (20+ cabinets). An experienced contractor can cut that time roughly in half. Each individual cabinet takes 15 to 30 minutes to assemble depending on the size and complexity.
Do kitchen cabinets ship fully assembled?
Only if you order them as assembled cabinets. RTA cabinets ship as flat-pack components that require on-site assembly. When ordering from Kitchen Cabinet Kings, you choose between RTA and assembled at checkout. Assembled orders add 7 business days to the lead time but arrive ready to install with no assembly required.
![See your dream kitchen in 3D [GET YOUR FREE DESIGN]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/see-your-dream-kitchen-in-3d.webp)
![Contractor Discount Program: Offering contractors and builders special volume discounts on all applicable orders [LEARN MORE]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/contractor-discount-program.webp)
![Explore our photo gallery [GET INSPIRED]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/explore-our-photo-gallery.webp)
![What everyone is saying about KCK [READ REVIEWS]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/what-everyone-is-saying-about-kck.webp)
![Get a cabinet sample [SHOP SAMPLES]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/get-a-cabinet-sample.webp)
![Pay over time, on your terms with Affirm [LEARN MORE]](https://cdn.kitchencabinetkings.com/blog/wp-content/uploads/pay-over-time-on-your-terms-with-affirm.webp)
